CAPITAL PROJECTS

The Capital Improvement Plan development begins in August of each year, and the plan is approved by the Board of Supervisors at the same time as the annual operating budget in April or May.

A Capital Project has a minimum established cost of $50,000 and a minimum useful life of five years. Generally, a capital project should either be a major expenditure for construction, purchase of land and existing structures, a communications and Information Technology project, or high dollar equipment apart from vehicles.

CURRENT PROJECTS

Status updates and spending as of 9/24/2024.

Sheriff Toughbooks

Status: 🟡 Procurement

Funding Source: County Funds

Budget: $182,034

Spent to Date: $0

Managing Department: Sheriff’s Office / Information Technology

Start Year: FY 2025

Summary

Purchase and replacement of Sheriff's Office Uniform Patrol and School Resource Officer's Panasonic Toughbook rugged computers.

Animal Control Parking Lot

Status: 🟡 Construction

Funding Source: County Funds & Donations

Budget: $121,165 (County Funds) & $8,400 (Donations)

Spent to Date: $121,978

Managing Department: Engineering

Start Year: FY 2025

Summary

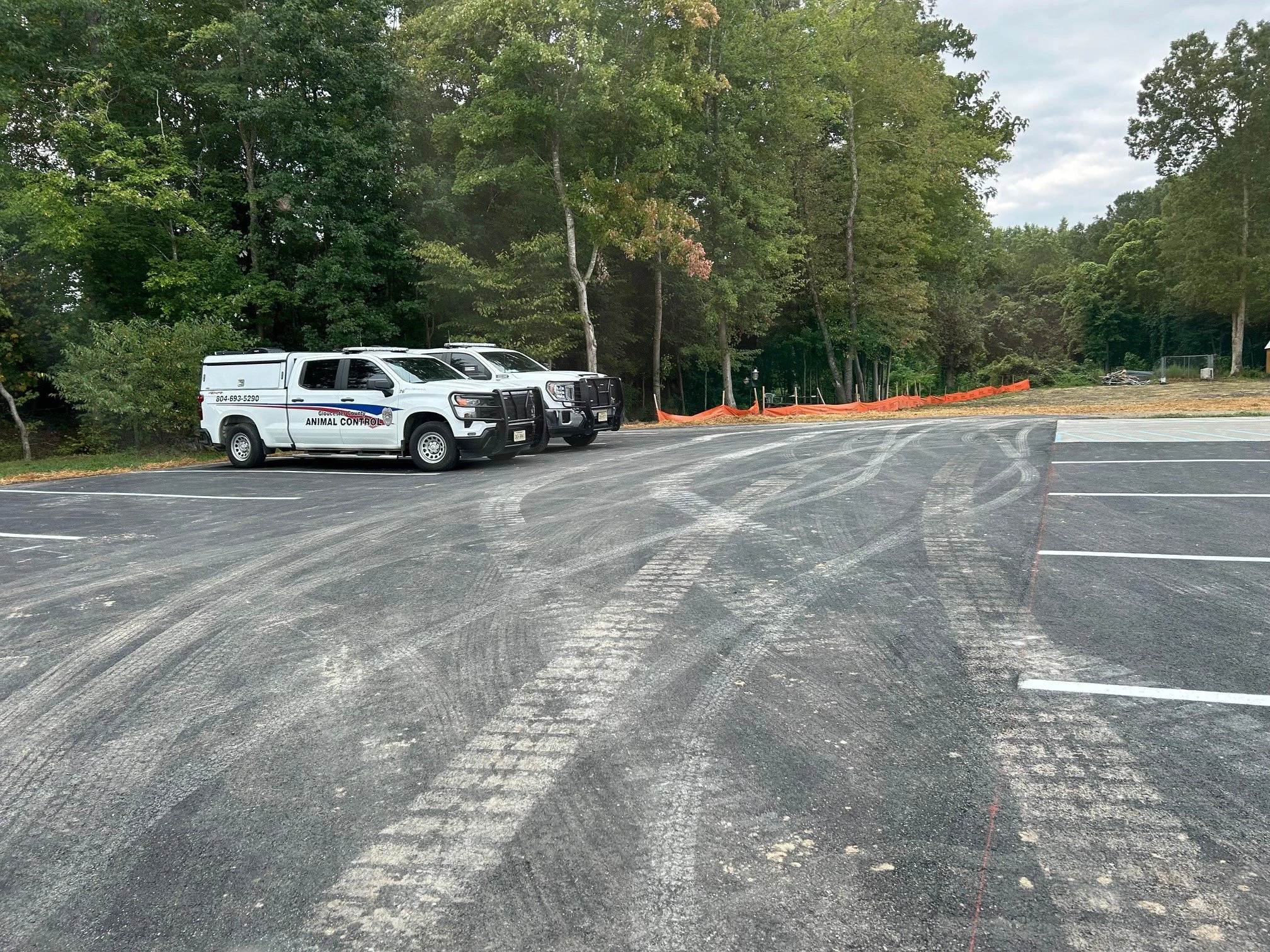

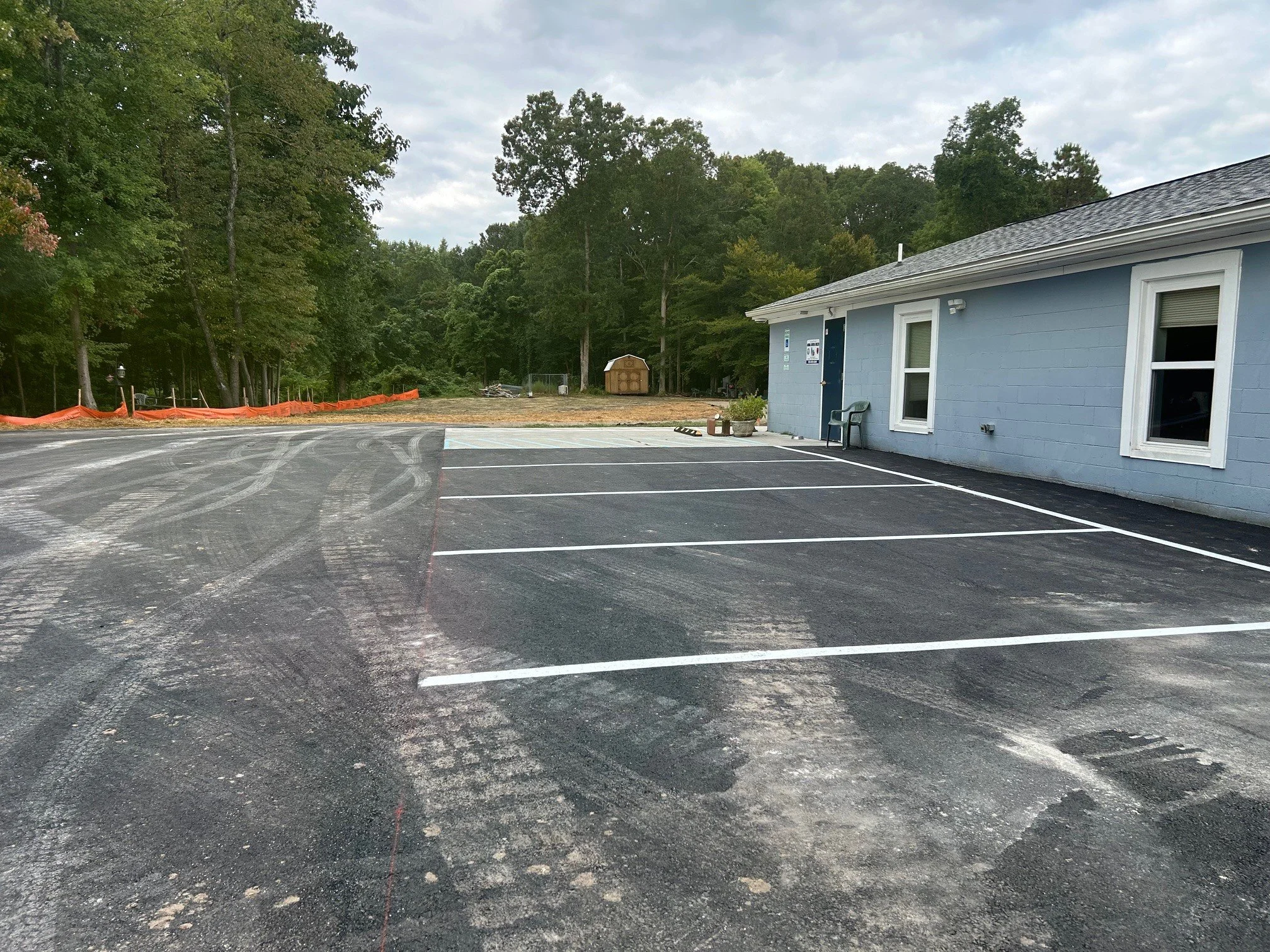

The paving project at Animal Control includes paving the parking lot, refurbishing, and installing new fencing of the animal runs.

Status Update

The paving of the Animal Control parking lot has been completed, and fencing installation is currently 25% finished. The project is on track to be completed by the end of December.

Older Adult Facility

Status: 🟡 Construction

Funding Source: County Funds

Budget: $67,401

Spent to Date: $63,125

Managing Department: Facilities Management

Start Year: FY 2023

Summary

An extensive remodel of the dining area and restrooms completed, as well as added storage for the Meals on Wheels supplies. Updated restrooms to meet ADA compliance, kitchen HVAC upgraded, added cabinets, fans, and lighting.

Status Update

The windows facing the market are scheduled for work, and cost estimates are being obtained for new overhangs at the front and side of the building. The kitchen renovation has been completed, and a new sign for the building has been ordered; delivery is pending.

Aberdeen Dredging

Status: 🟡 Design / Planning

Funding Source: Virginia Port Authority Grant

Budget: $1,434,000

Spent to Date: $85,832

Managing Department: Engineering / Administration

Start Year: FY 2023

Summary

Shoaling at Aberdeen Creek has created detrimental waterway access problems. This project is to dredge the channel and provide safe, convenient, waterway access. The original CIP submission also included Timberneck Creek, but funding is currently only available for Aberdeen Creek. Funding will be sought for Timberneck Creek after completion of Aberdeen Creek.

Status Update

Awaiting resolution for disposing of spoils.

Historic Building Conditions Assessment

Status: 🟡 In Progress

Funding Source: Tourism Fund Balance

Budget: $250,000

Spent to Date: $96,624

Managing Department: Parks, Recreation & Tourism

Start Year: FY 2023

Status Update

The 50% draft report has been received and is currently under review. The 90% draft report is pending, and potential grant funding opportunities are being explored.

Summary

The Colonial Courthouse dates back to 1766. This building and other historic buildings throughout the campus require evaluation for maintenance and historic preservation. This conditions assessment will provide the basis to preserve one of the County's most precious assets. Preservation projects will be requested in future years based on the findings of this condition assessment and available funding opportunities.

Building 4 Renovation

Status: 🟡 Planning / Design

Funding Source: County Funds

Budget: $896,754

Spent to Date: $216,035

Managing Department: Engineering

Start Year: FY 2023

Summary

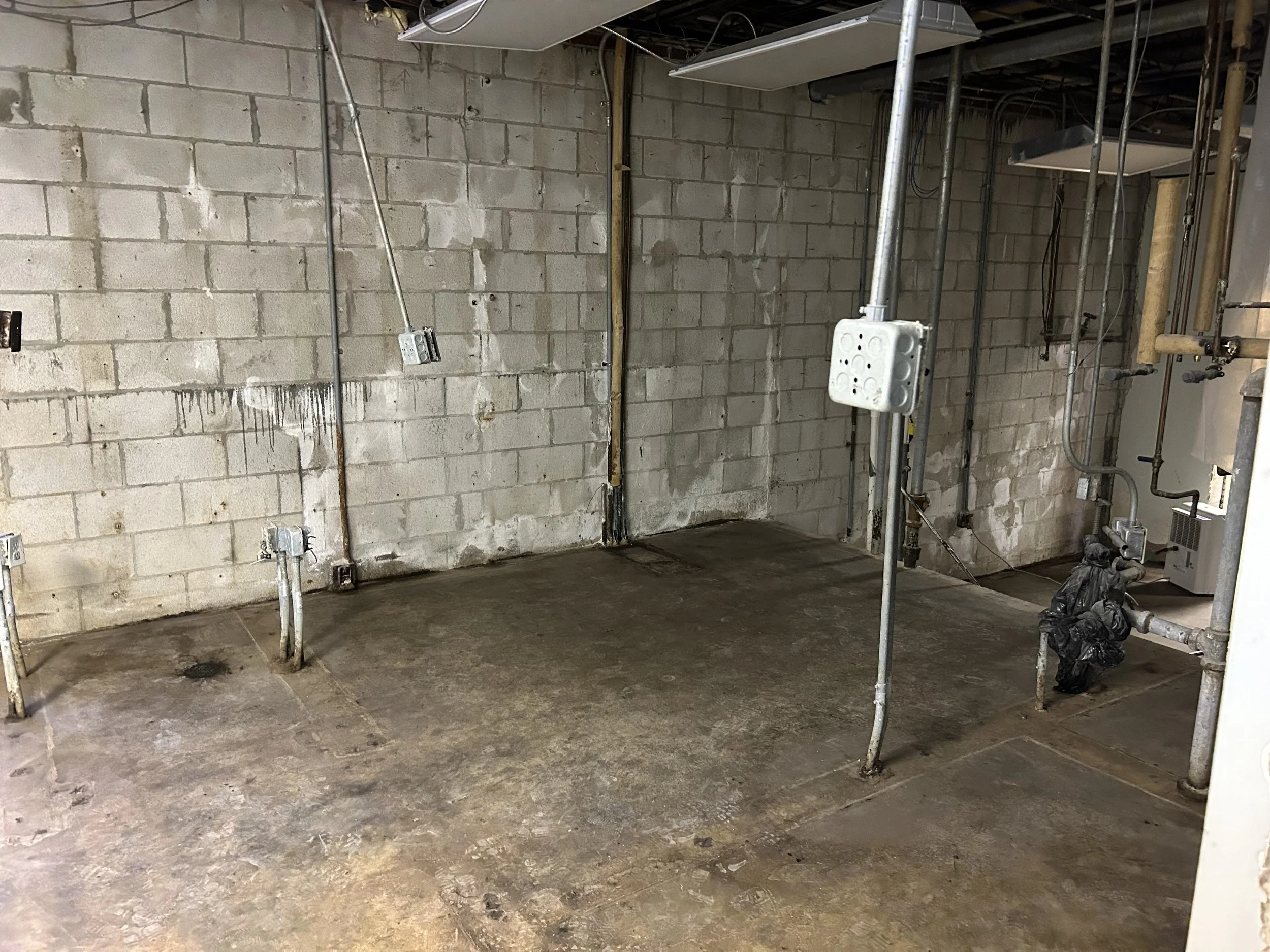

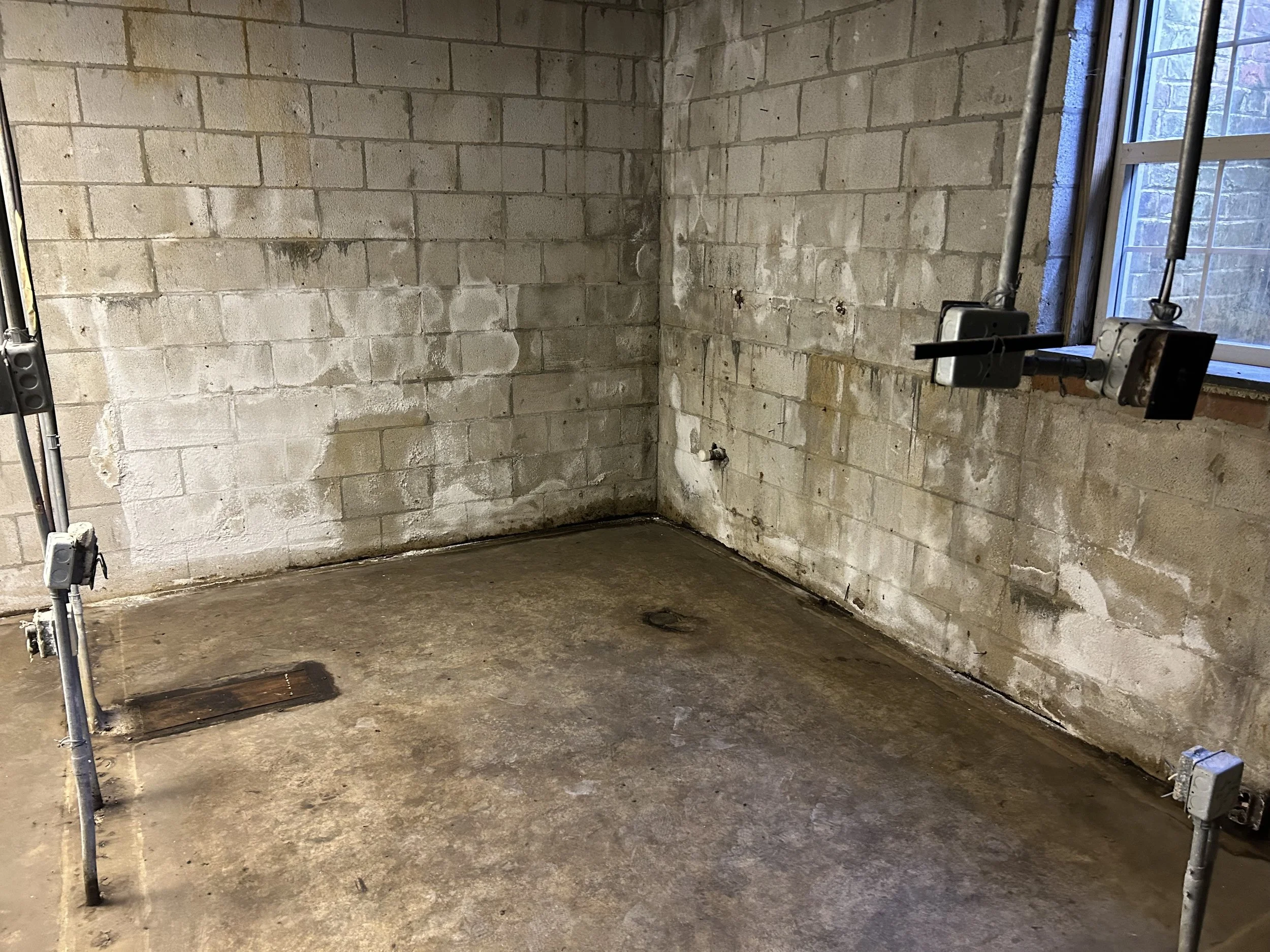

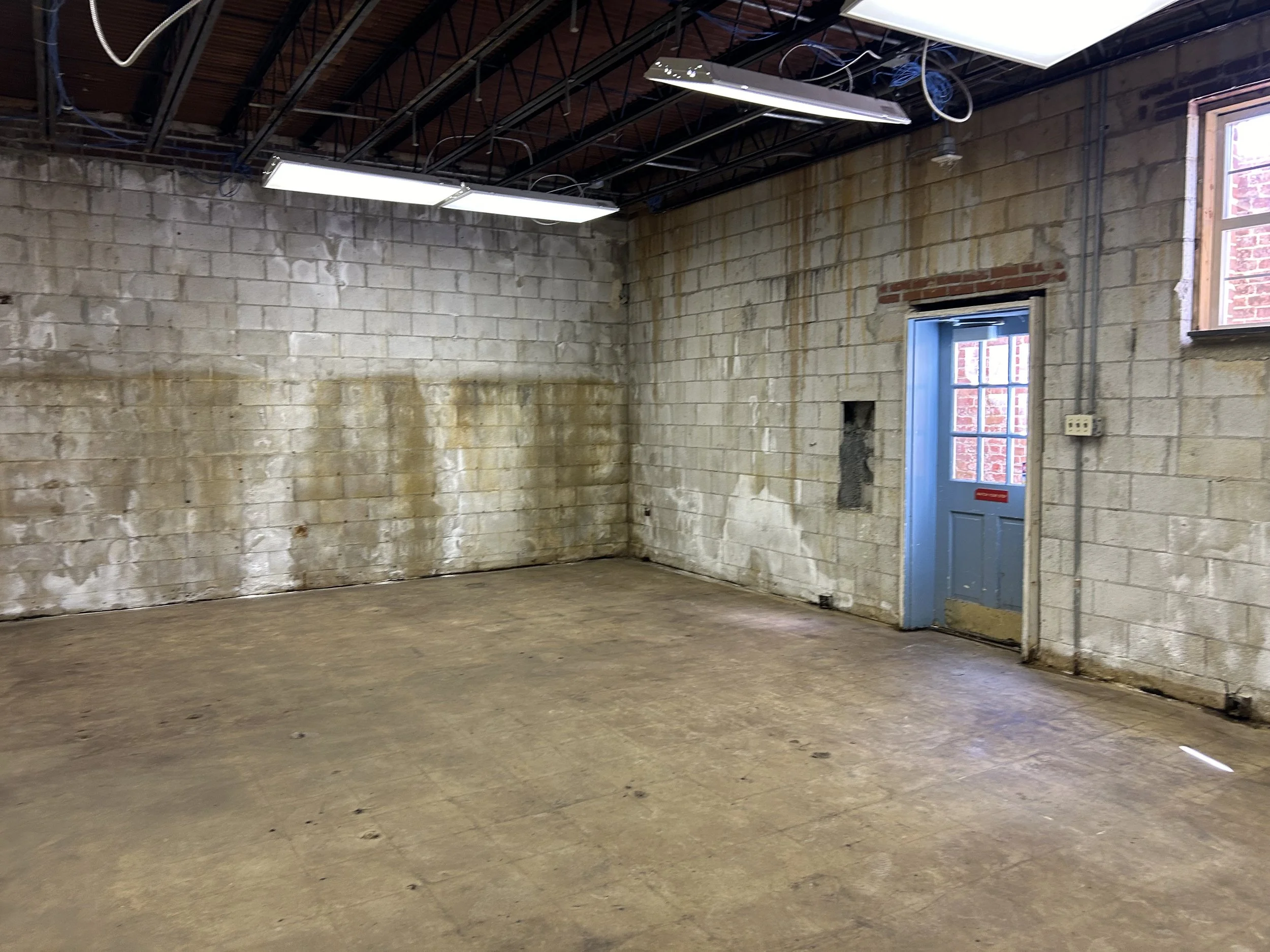

Building 4 is currently undergoing asbestos removal, waterproofing, electrical rewiring, and replacement of the incoming electrical feed and mechanical ducting so that the space can be utilized without any adverse health or safety risks.

Status Update

A notice of intent to award has been posted, and the contract is being finalized. A drop inlet has been installed, and the project is set to begin on 12/2. Drainage work is 95% complete, with the north side of the building fully finished. A new road and ramp have been completed. Work on the south side is done, but the trench under the sidewalk is still in progress. The necessary materials are expected to arrive the first week of December.

Woodville Park Paving

Status: 🟡 Procurement

Funding Source: County Funds

Budget: $18,366

Spent to Date: $3,300

Managing Department: Engineering

Start Year: FY 2025

Summary

This paving project aims to create a second entrance to the parking lot for Fields 1 and 2 at Woodville Park. Currently, the park has only one entrance, which can cause traffic challenges during busy periods with high activity levels.

Status Update

Purchase Orders were issued for Fields 1 & 2 improvements, including the VDOT permit, grading work, and the addition of rock, all planned to be completed before Christmas. Tree clearing at the second entrance was completed. Work on the second entrance is scheduled to begin in early Spring.

COMPLETED PROJECTS

Status updates and spending as of 9/24/2024.

Library Renovation

Status: 🟢 Complete

Funding Source: Main Street Preservation Trust ($200,000) and ARPA Funds ($451,025)

Budget: $651,025

Spent to Date: $705,575

Managing Department: Multiple

Start Year: FY 2023

Estimated Completion Date: June 30, 2024

Summary

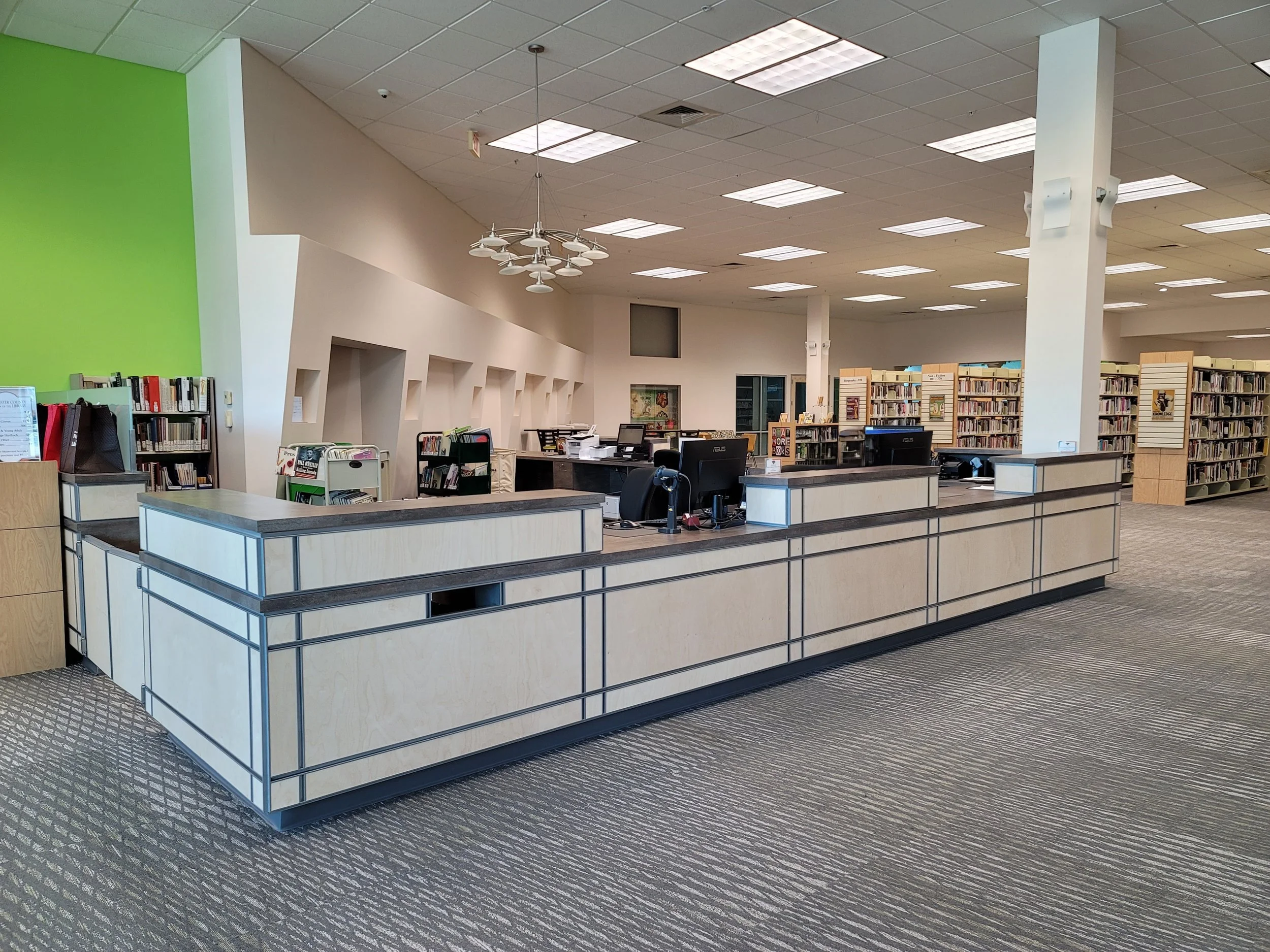

Full interior renovation of the Main Library that includes three new study rooms, a new children's area, story time area, new floors, and circulation desk.

Bus Garage Conversion

Status: 🟢 Complete

Funding Source: County Funds

Budget: $243,631

Spent to Date: $242,000

Managing Department: Engineering

Start Year: FY 2023

Summary

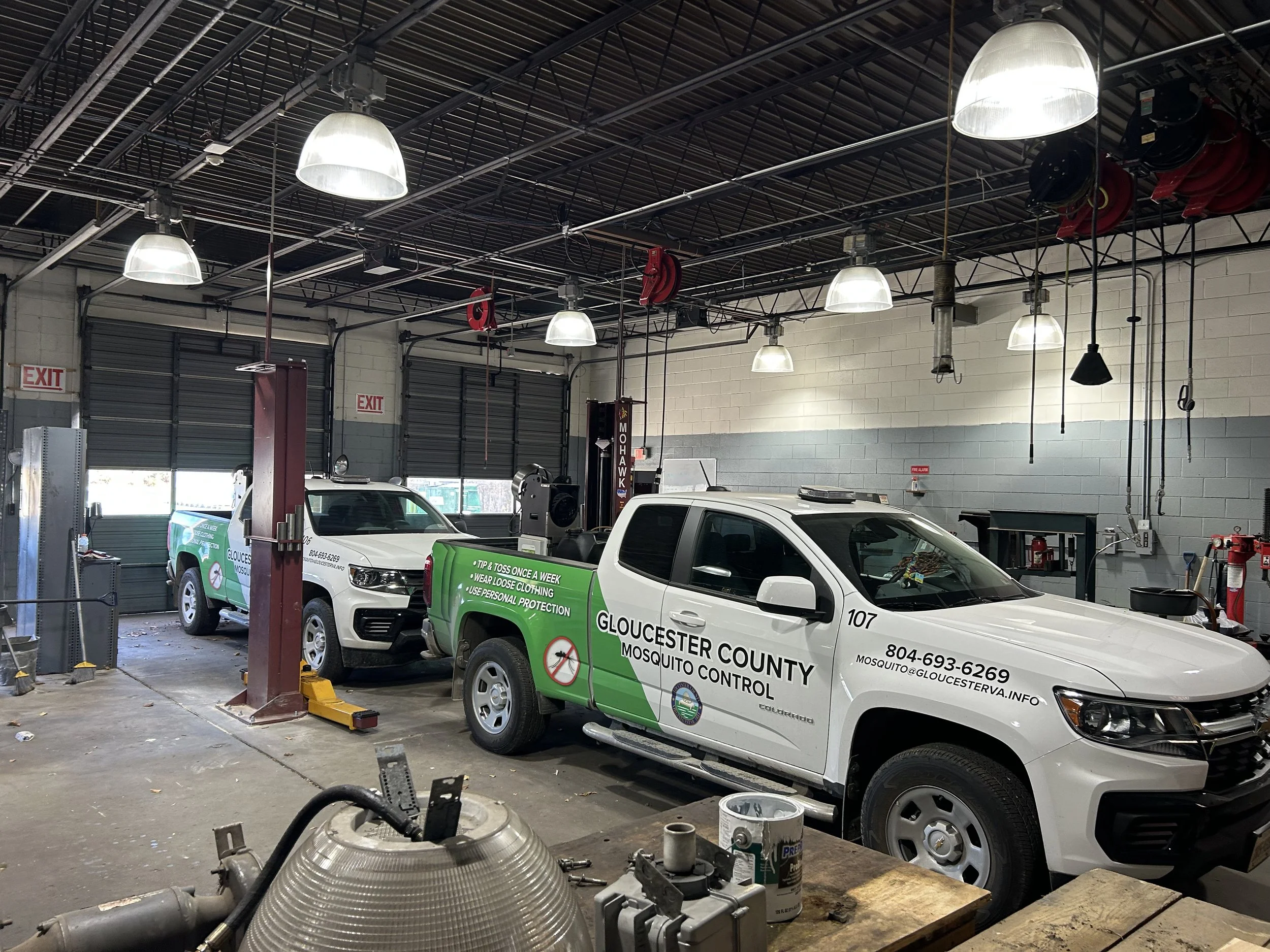

The ‘old bus garage’ has been transformed into the County Garage, Mosquito Control, and Utility Shop.

The building has 6 working bays and a parts bay.  It also has space in the Utilities bays for work benches and repairs of equipment.
The Utilities Field crews also have offices that were renovated and have new lights, new floors, and new paint. With the location having a paved yard as well as the indoor bays. The facility comes with a fueling station that supports the County’s needs and adds redundancy for emergencies.

Status Update

Construction complete. Awaiting final vendor invoices.

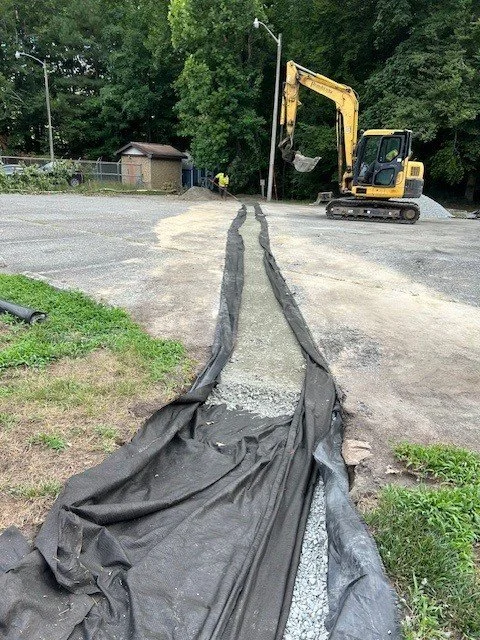

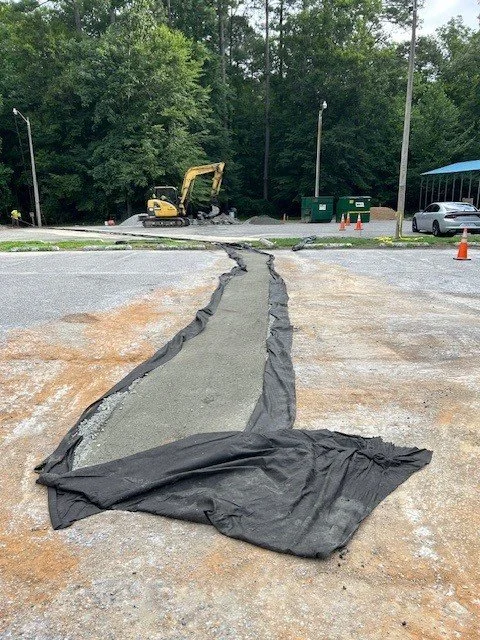

Sheriff Parking Lot Paving

Status: 🟢 Complete

Funding Source: County Funds

Budget: $190,000

Spent to Date: $189,781

Managing Department: Engineering

Start Year: FY 2025

Summary

New and replacement paving projects are proposed to ensure safe driving and pedestrian conditions. These projects are prioritized based upon conditions and public need and placed into a rotation for replacement based upon anticipated life.

Jail Console

Status: 🟢 Complete

Funding Source: County Funds

Budget: $209,826

Spent to Date: $212,494

Managing Department: Sheriff

Start Year: FY 2024

Summary

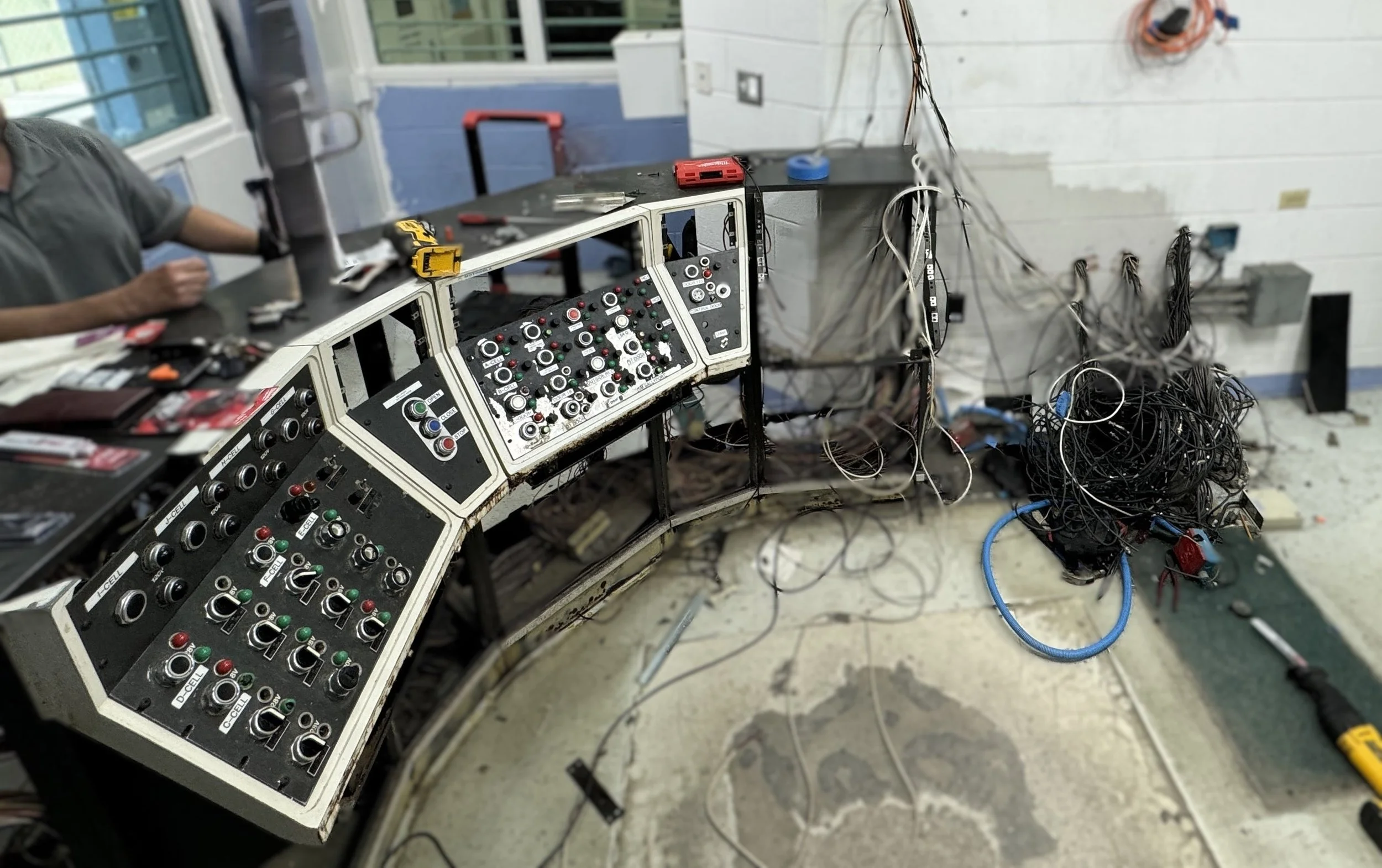

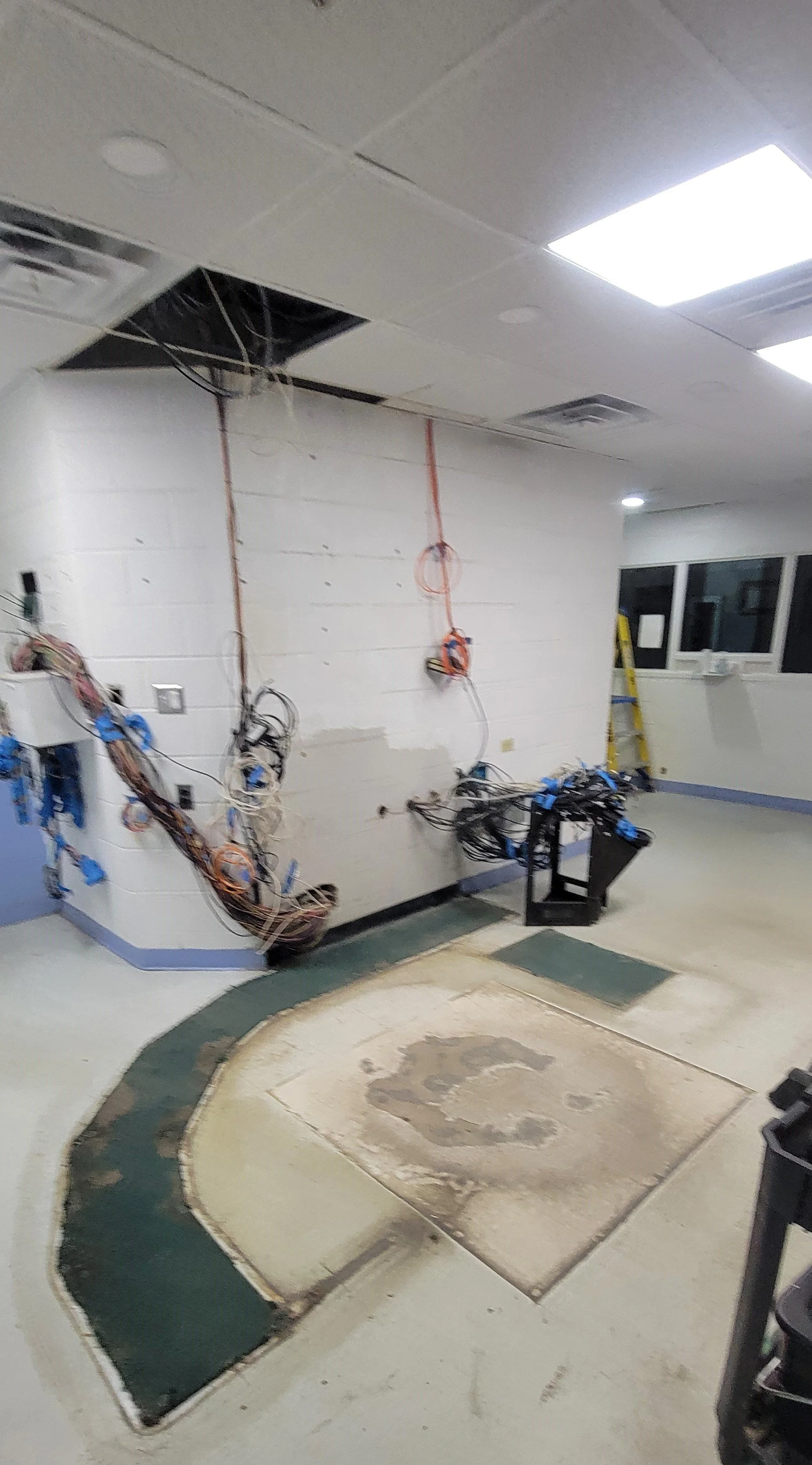

Removal of the current 40 year old outdated access control system, and installation of a new system that is being put in place for the safety and security of inmates and corrections officers.

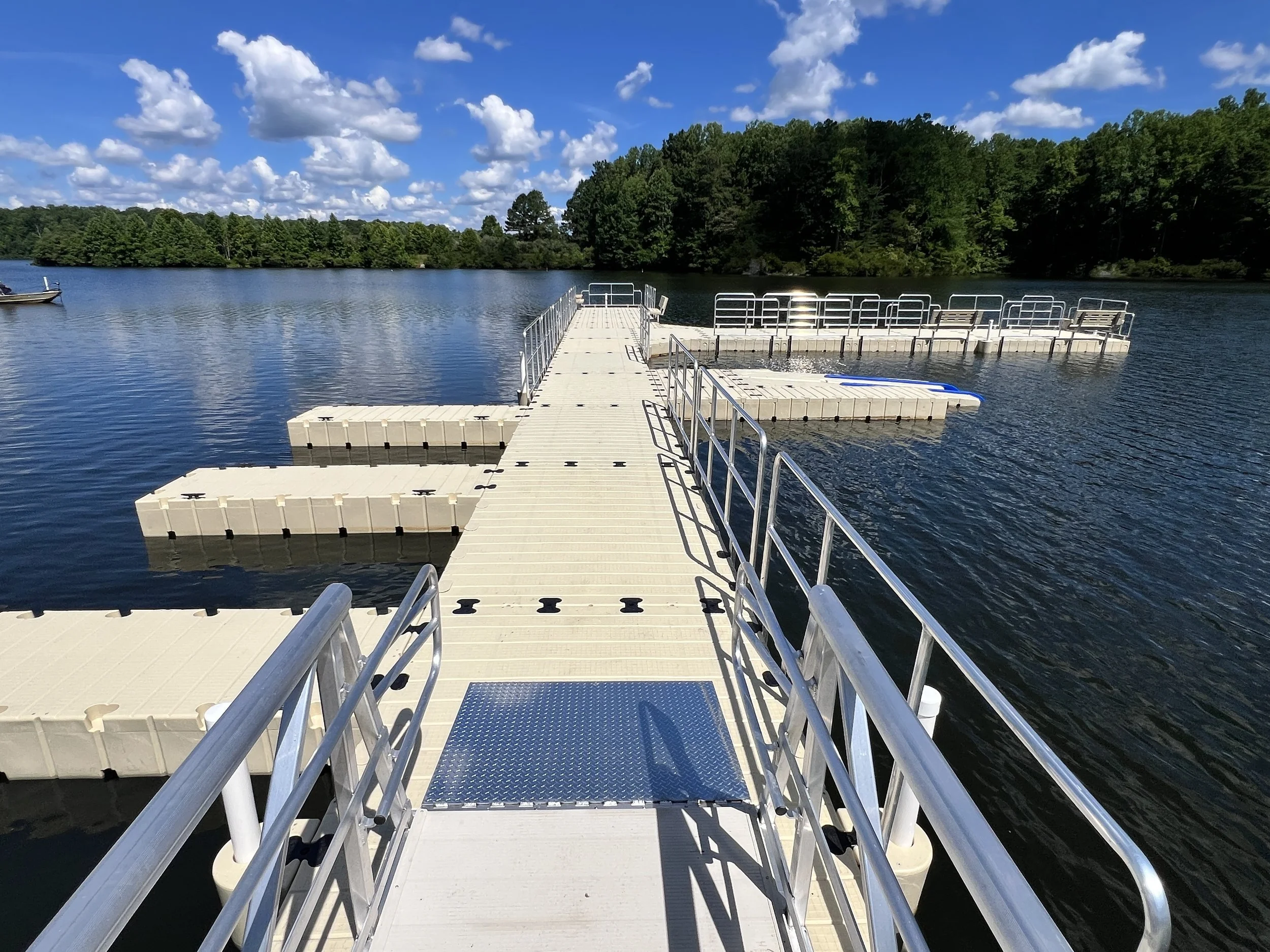

Beaverdam Floating Dock

Status: 🟢 Complete

Funding Source: County Funds

Budget: $150,000

Spent to Date: $145,477

Managing Department: Parks, Recreation & Tourism

Start Year: FY 2024

Summary

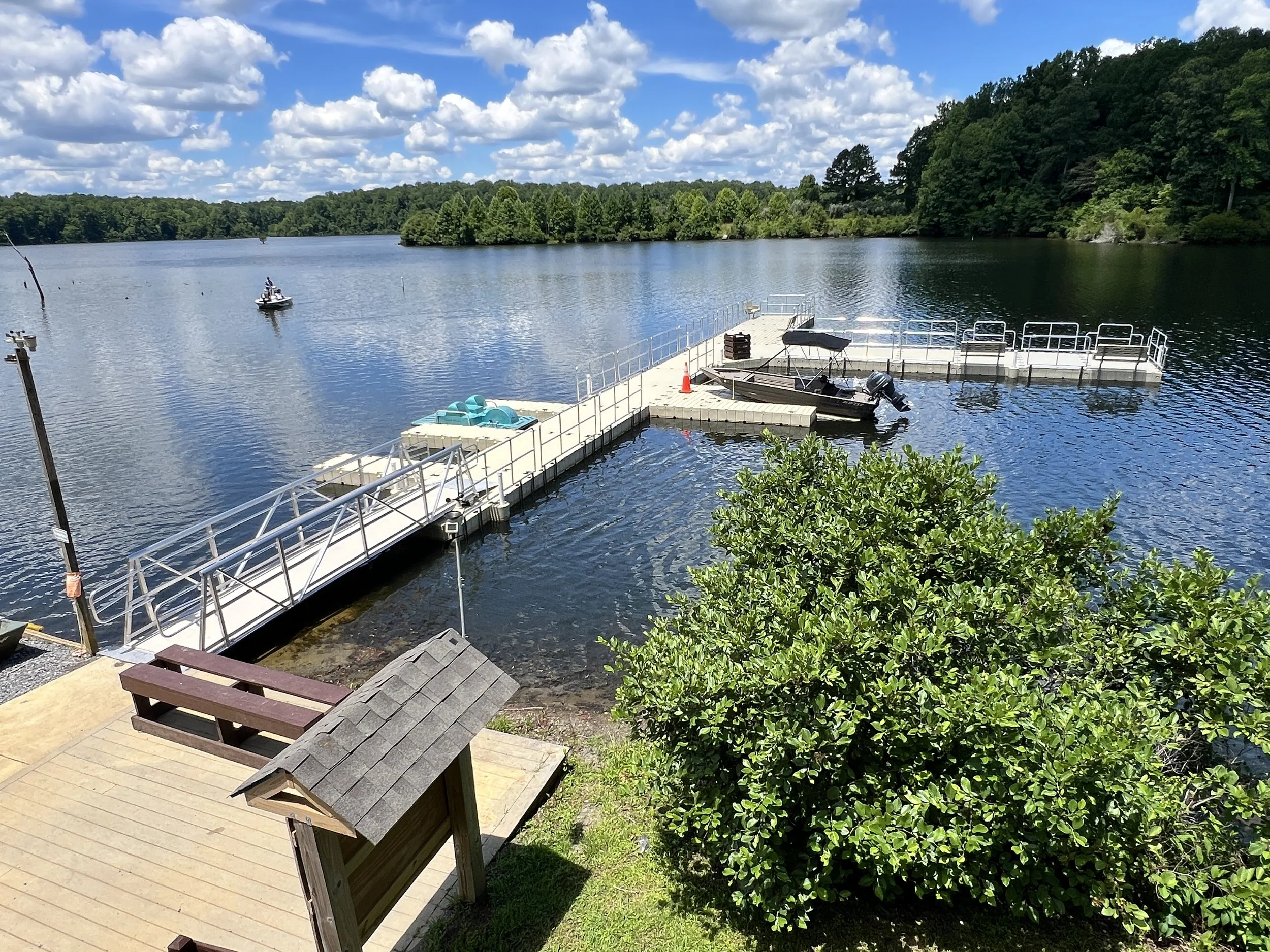

Replacement of of existing floating pier at the main entrance of Beaverdam Park.

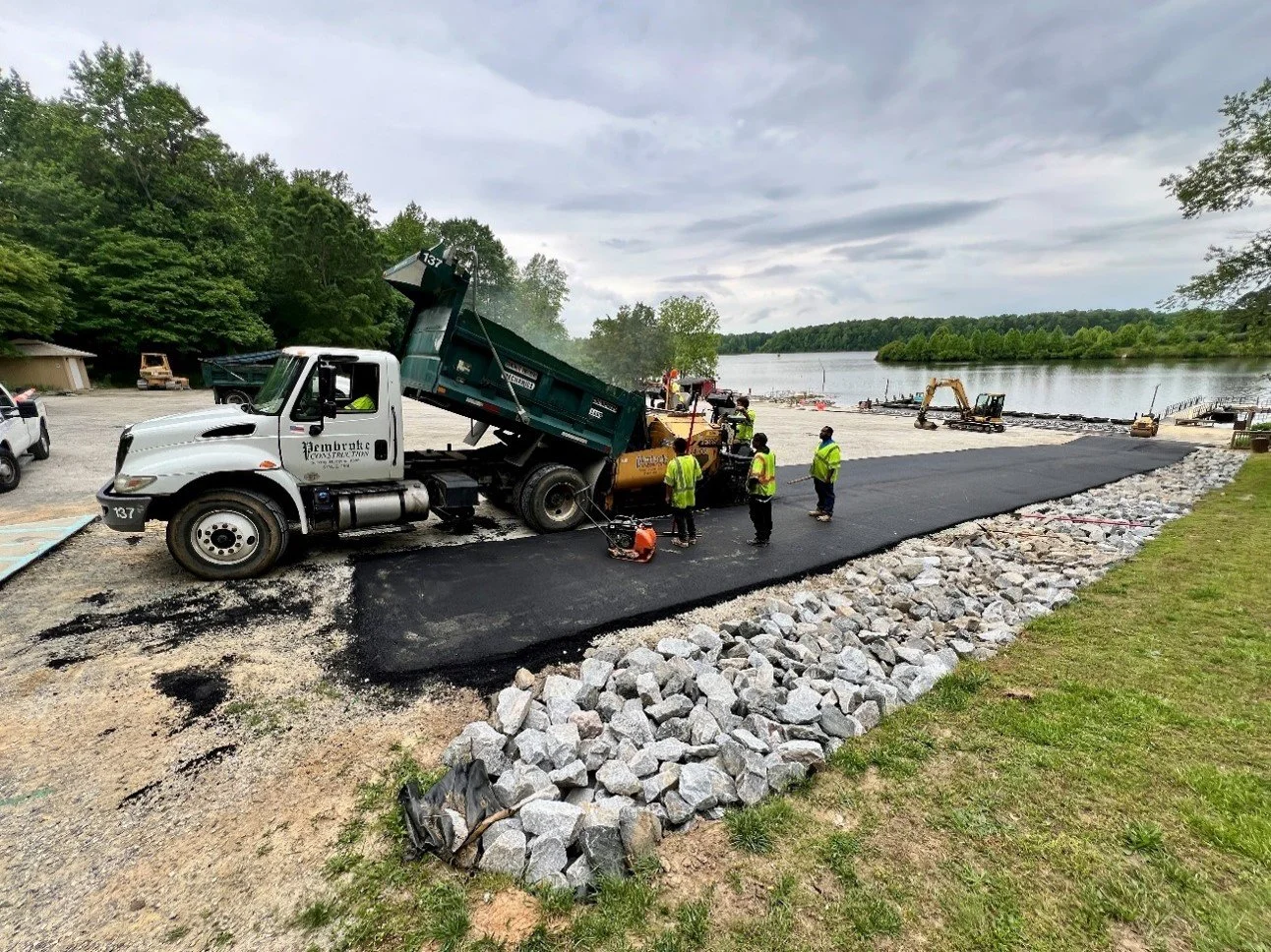

Beaverdam Parking Lot Paving

Status: 🟢 Complete

Funding Source: County Funds

Budget: $375,834

Spent to Date: $378,980

Managing Department: Engineering

Start Year: FY 2024

Summary

Projects slated for FY24 are the Stewart Building Parking Lot, Social Services Parking lot, and Beaverdam Parking lot. New and replacement paving projects are proposed to ensure safe driving and pedestrian conditions. These projects are prioritized based upon conditions and public need and placed into a rotation for replacement based upon anticipated life.

Status Update

Other FY24 paving projects included the Stewart Building Parking Lot and the Social Services Parking Lot. New Paving projects slated for FY25 include the Sheriff's Office and Animal Control.

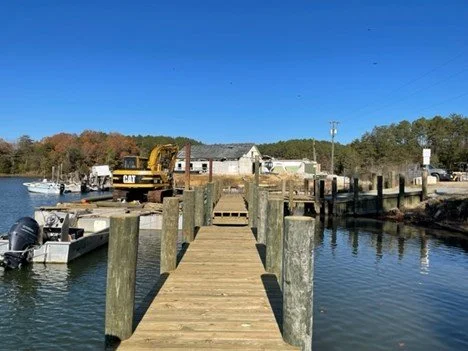

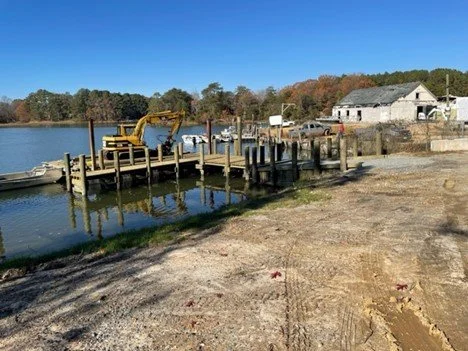

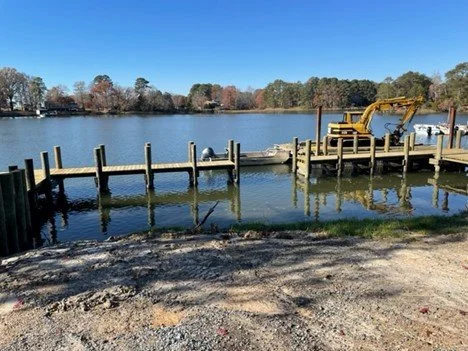

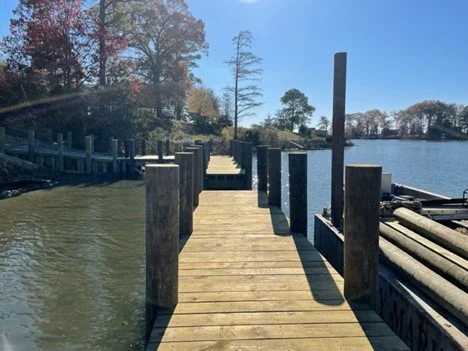

Aberdeen Pier Rehab

Status: 🟢 Complete

Funding Source: State Grant ($333,778) and County Funds ($111,263)

Budget: $445,041

Final Project Cost: $455,070

Managing Department: Engineering

Start Year: FY 2023

Completion Date: January 4, 2024

Summary

The County closed two commercial piers to motor traffic in September of 2021 to prevent further damage or harm to users due to the state they were in. This project rehabilitated these piers to be rated for motor vehicle and commercial use.

PR&T ADA Improvements

Status: 🟢 Complete

Funding Source: County Funds

Budget: $108,075

Spent to Date: $100,789

Managing Department: Parks, Recreation & Tourism

Start Year: FY 2022

Completion Date: June 6, 2024

Summary

Five handicap parking spaces were installed at Ark Park, as well as sidewalks from the spaces to the basketball court, playground, athletic fields, and dug outs.

Status Update

Ark Park ADA Improvements Complete. FY25 Park ADA Improvements to be determined.

Ark Park Improvements

Status: 🟢 Complete

Funding Source: Park Partner Donations ($59,919) and County Funds ($63,381)

Budget: $123,300

Final Project Cost: $123,167

Managing Department: Parks, Recreation & Tourism

Start Year: FY 2022

Completion Date: January 1, 2024

Summary

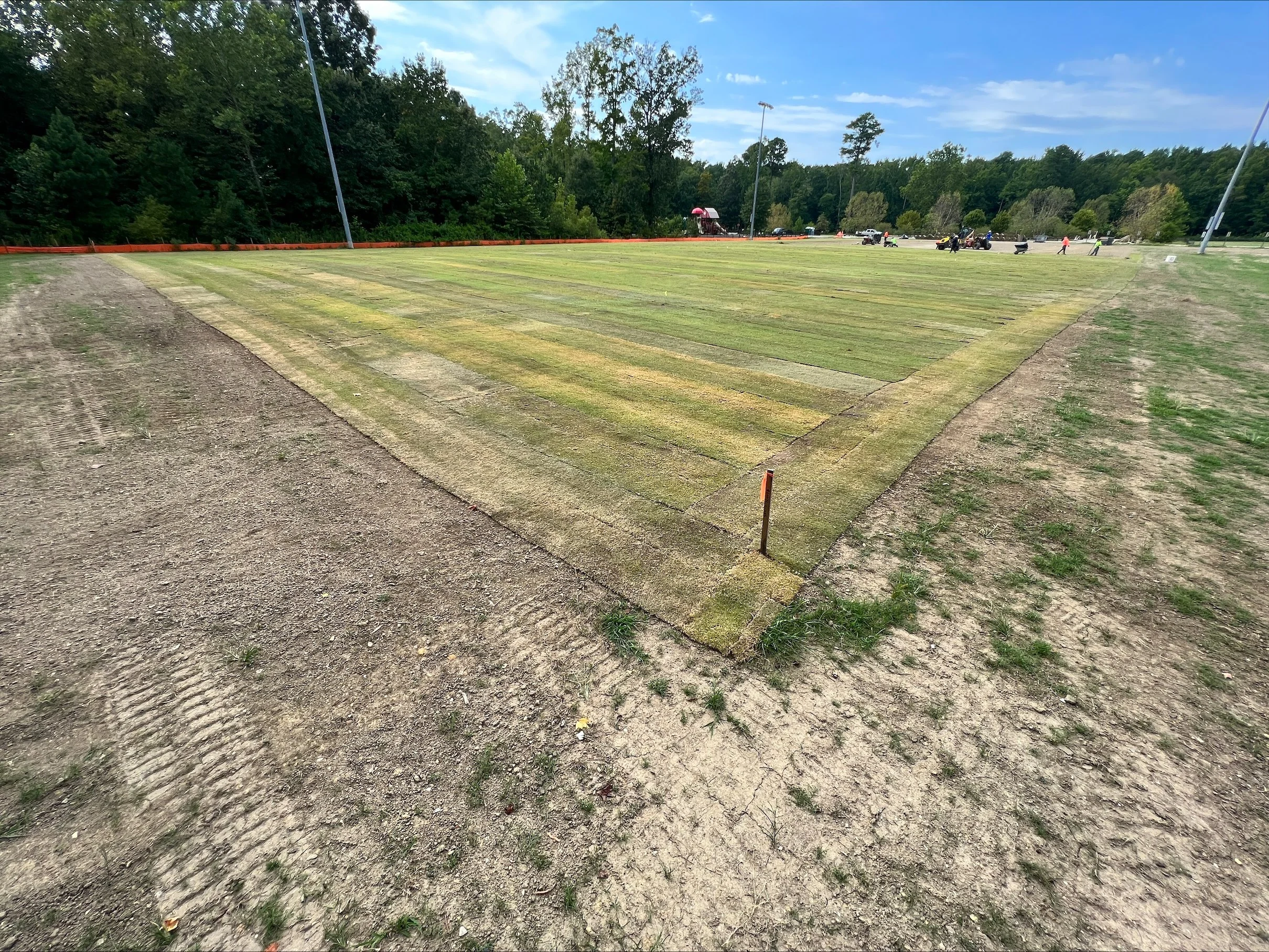

Grounds crew sodded around court, extended parking lot with fill dirt from Beaverdam as well as new gravel. Improvements include, basketball court renovations, installation of Pickleball courts, painting, and installation of fence.

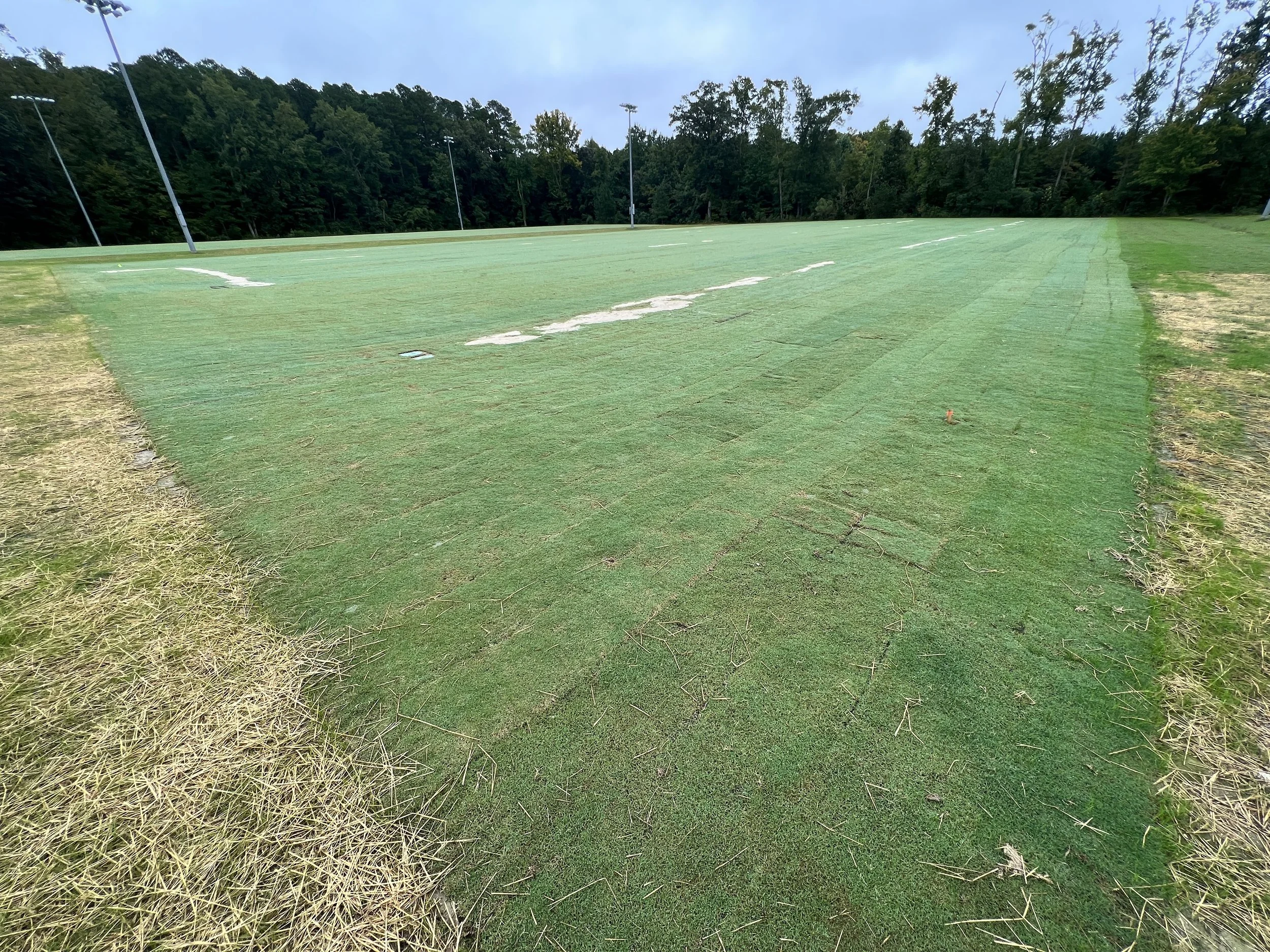

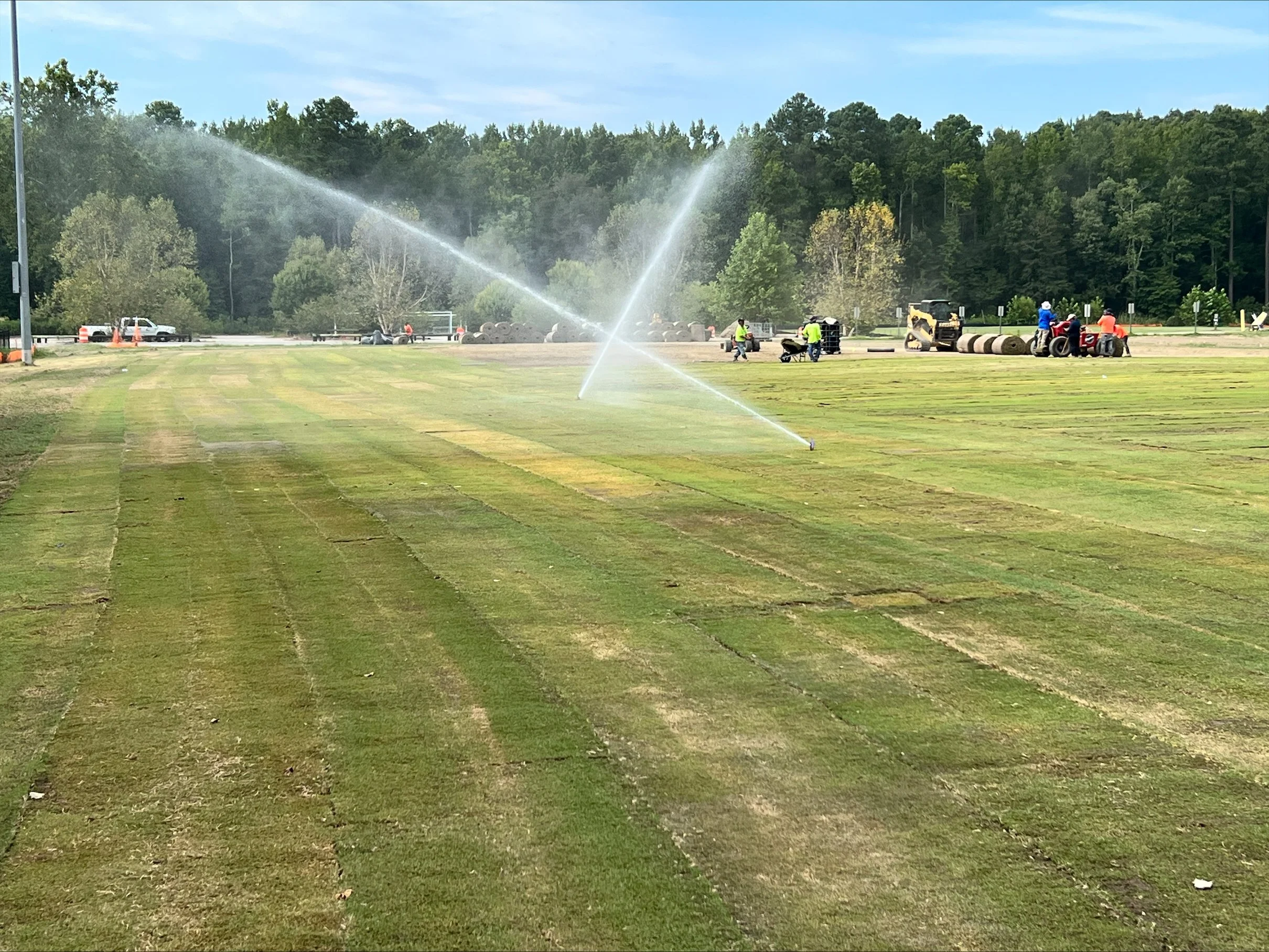

Woodville Park Fields

Status: 🟢 Complete

Funding Source: County Funds

Budget: $907,753

Final Project Cost: $907,777

Managing Department: Parks, Recreation & Tourism

Start Year: FY 2023

Completion Date: December 7, 2023

Summary

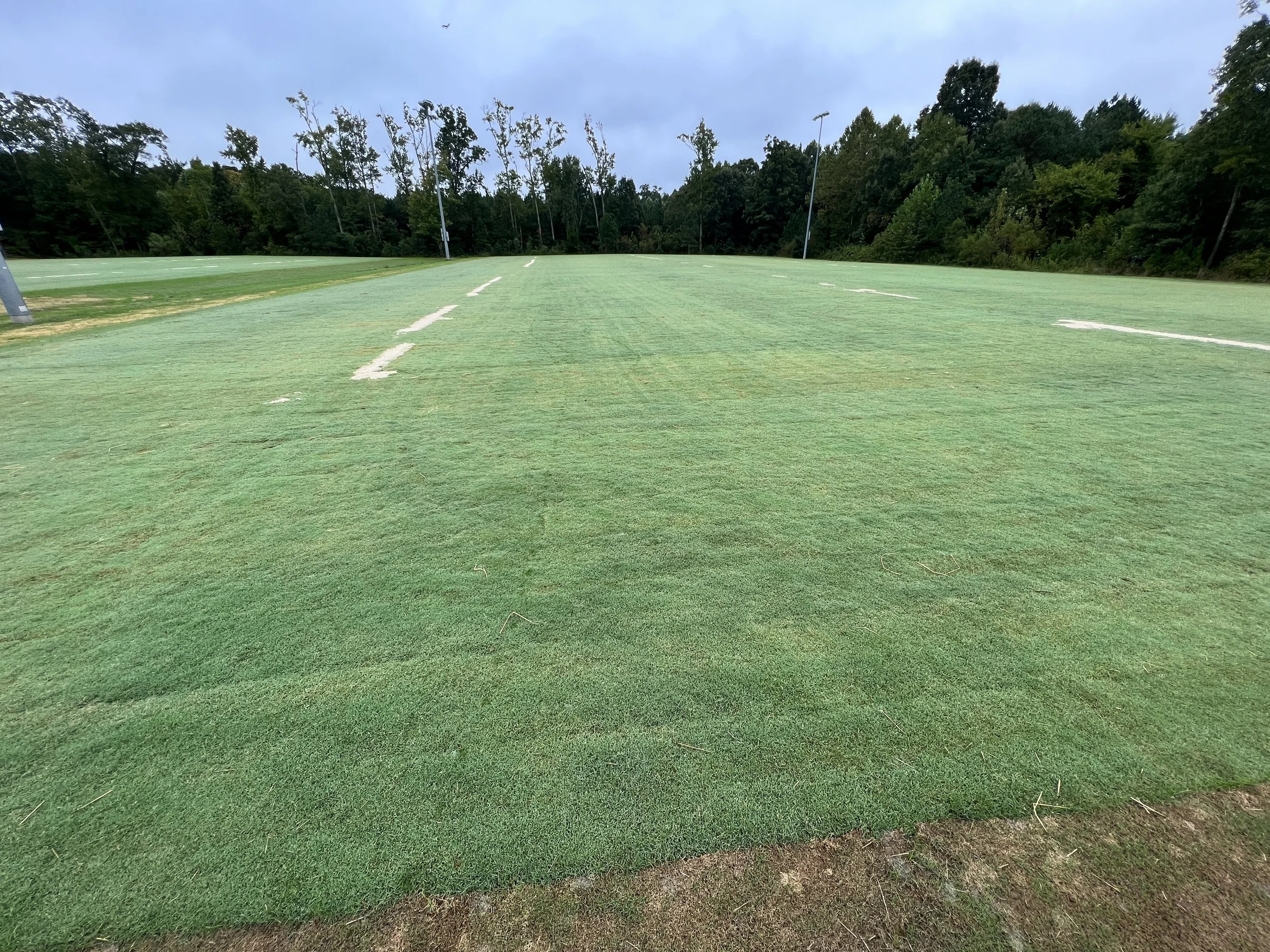

The Woodville Park Fields required improvements due to the inconsistency and unsafe nature of the playable areas on the athletic fields. Prior to project completion, the area was difficult to play on some fields, and nearly impossible to play on other fields. The turf was tough to maintain during severe dry spells without irrigation. With the fields being renovated, safe and playable athletic fields are provided for public use with more play expected and encouraged for years to come.
